Report · Sep 2026
EHR Implementation Cost Overrun Statistics: 2026 Report
Published · Updated
Most hospitals and practices that replace their electronic health record (EHR) system end up spending more than their board approved, much of it on extra consultants and staff. We compared budget and final spend on 412 EHR projects to see how large the overruns are and where the money goes.
Our analysts compared the board-approved budget at contract signing with total project spend twelve months after go-live for 412 EHR implementations that went live between 2019 and 2025. The sample covers independent practices, physician groups, community hospitals, academic medical centers and multi-hospital systems on every major vendor platform. The tables below cover overrun by organization type, where overrun dollars go, go-live approach and project duration, the post go-live productivity dip, and the year-by-year trend since 2019.
EHR Cost Overruns by Organization Type
Overrun magnitude scales with the size of the organization signing the contract. The table below compares the average approved budget at signing against average recognized spend twelve months after go-live for each of the five buyer categories in the sample. Budget figures are the board-approved totals recorded at contract signing, and spend figures include vendor license, implementation services, internal labor charged to the project, hardware and infrastructure.

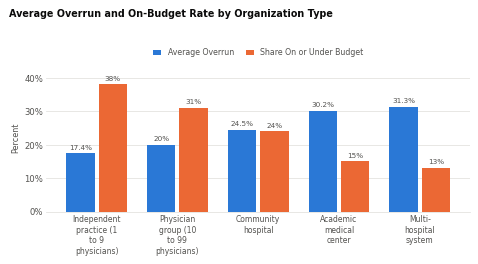

| Organization type | Avg. approved budget | Avg. spend at 12 months | Avg. overrun | On or under budget |
|---|---|---|---|---|
| Independent practice (1 to 9 physicians) | $340,000 | $399,000 | 17.4% | 38% |
| Physician group (10 to 99 physicians) | $2,150,000 | $2,580,000 | 20.0% | 31% |
| Community hospital | $18,400,000 | $22,900,000 | 24.5% | 24% |
| Academic medical center | $86,000,000 | $112,000,000 | 30.2% | 15% |
| Multi-hospital system | $214,000,000 | $281,000,000 | 31.3% | 13% |
Budget is the board-approved total at contract signing; spend is recognized project cost at twelve months past go-live.
- We found that 113 of the 412 projects, or 27.4 percent, closed at or under their approved budget, which makes overrun the common outcome rather than the universal one. Independent practices posted the best record at 45 of 118 projects on or under budget, and multi-hospital systems the worst at 6 of 46. Henry Ford Health System's publicly reported $353 million EHR overhaul, which finished slightly under budget, is the kind of result that sits in that 27.4 percent.
- Our data showed overrun magnitude rising with organization size at every step, from 17.4 percent at independent practices to 31.3 percent at multi-hospital systems. Ranking the five categories by average overrun produces the same order as ranking them by average approved budget, with no crossovers. Sample counts were 118 independent practices, 104 physician groups, 96 community hospitals, 48 academic medical centers and 46 multi-hospital systems.
- For health system leaders, an EHR budget should be treated as a floor, not a ceiling. The mean overrun was 22.7%, or 30.1% weighted by dollars, and only 27.4% of projects finished on or under budget. Larger organizations should plan for the biggest overruns, which reached 31.3% at multi-hospital systems.
Where the Overrun Dollars Go
Every overrun in the sample was coded to one of seven spending lines, and the shares below sum to the full overrun pool. The dollar column shows how the same split lands on an average community hospital project. A project could report several lines at once, so the reporting column does not sum to 100 percent while the dollar share column does.

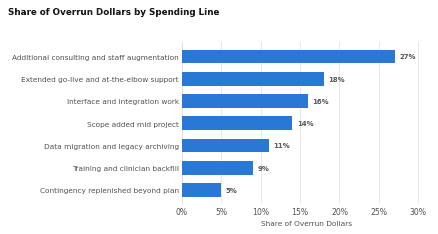

| Overrun component | Share of overrun dollars | Projects reporting the line | Avg. $ per community hospital |
|---|---|---|---|
| Additional consulting and staff augmentation | 27% | 88% | $1,215,000 |
| Extended go-live and at-the-elbow support | 18% | 74% | $810,000 |
| Interface and integration work | 16% | 69% | $720,000 |
| Scope added mid project | 14% | 57% | $630,000 |
| Data migration and legacy archiving | 11% | 52% | $495,000 |
| Training and clinician backfill | 9% | 46% | $405,000 |
| Contingency replenished beyond plan | 5% | 31% | $225,000 |
Dollar column applies the same share to an average community hospital overrun.
The three largest lines are all labor, and together they account for 61 percent of every overrun dollar in the sample. Additional consulting and staff augmentation alone absorbs 27 percent and appears on 88 percent of the 299 projects that ran over, which makes it the single most reliable predictor that a budget is about to move. Extended go-live and at-the-elbow support takes another 18 percent, almost always because command center coverage that was scoped for two weeks ran for six or eight. Interface and integration work takes 16 percent, and in the acute sample it was driven less by the count of interfaces than by the count of downstream systems nobody inventoried until build was underway: cardiology, oncology, lab middleware, bed management and the payer-facing clearinghouse connections that revenue cycle depends on. Fifteen of the 96 community hospital projects reported an interface line larger than their entire original training budget.
The remaining four lines are smaller but harder to defend in a board meeting. Scope added mid project takes 14 percent, data migration and legacy archiving 11 percent, and training and clinician backfill 9 percent. Contingency replenished beyond plan is the smallest at 5 percent, for a mechanical reason: most projects had exhausted the original contingency line before anyone conceded the budget was broken, so the replenishment shows up late and small. Applied to a community hospital, where the average gap between the $18,400,000 approved and the $22,900,000 spent is $4,500,000, the same seven shares distribute across the dollar column in the table above.
Overrun by Go-Live Approach and Project Duration
Go-live design turned out to be a better predictor of overrun than vendor choice. The table groups all 412 projects by activation approach, with average planned duration and average schedule slip alongside the overrun figure. Planned duration runs from contract signature to the first production go-live date, and slip is measured against that original date.
| Go-live approach | Projects | Avg. planned duration | Avg. schedule slip | Avg. overrun |
|---|---|---|---|---|
| Big bang, single facility | 142 | 11 | 2.1 | 16.0% |
| Big bang, multi-facility | 84 | 16 | 3.4 | 24.8% |
| Phased by facility or region | 96 | 24 | 6.2 | 30.6% |
| Phased by application module | 62 | 21 | 4.6 | 25.2% |
| Hybrid: big bang clinical, phased revenue cycle | 28 | 19 | 2.4 | 17.9% |
Planned duration and schedule slip are in months from contract signature to first production go-live.
- We found that big bang activations at a single facility carried the lowest average overrun at 16.0 percent across the shortest average planned duration at 11 months, while phased rollouts by facility or region carried the highest at 30.6 percent across an average planned duration of 24 months. The pattern is consistent with the reasoning health systems give publicly for choosing a single activation date, though the largest systems in the sample rarely have that option.
- Shorter, simpler rollouts keep costs closer to plan. Single-facility big bang go-lives averaged a 16.0% overrun, against 30.6% for phased rollouts by facility. Each month of schedule slip added about 3.4 points of overrun, so tight timelines are likely to remain the best cost control.
- We observed the 113 on-or-under-budget projects concentrating in the shorter formats: 52 of 142 single-facility big bang projects, 9 of 28 hybrid projects and 16 of 62 phased-by-module projects, against 17 of 96 phased-by-facility projects. Northwell Health's publicly reported $1.2 billion Epic program, phased by region across two years, sits squarely in the category with the thinnest odds. Phased programs are not doomed by design, and the largest organizations in the sample had sound reasons for choosing them, but the budget they present at signing rarely carries enough contingency for the extra year of parallel operations.
The Post Go-Live Productivity Dip
Throughput falls after every go-live in the sample, and the recovery curve is the cost buyers almost never put in a capital request. The table tracks clinician throughput against the pre go-live baseline for each organization type. Throughput is indexed to the twelve weeks preceding go-live, and the cost column values lost volume at each organization's own net revenue per unit.
| Organization type | Peak throughput drop | Month of trough | Months to baseline | Unbudgeted cost per clinician |
|---|---|---|---|---|
| Independent practice (1 to 9 physicians) | -21% | Month 1 | 3.4 | $18,400 |
| Physician group (10 to 99 physicians) | -24% | Month 2 | 4.8 | $26,700 |
| Community hospital | -27% | Month 2 | 6.1 | $34,900 |
| Academic medical center | -31% | Month 2 | 8.3 | $48,200 |
| Multi-hospital system | -29% | Month 2 | 7.5 | $41,600 |
Throughput indexed to the twelve weeks preceding go-live; unbudgeted cost is per clinician over the first twelve months.
Across the 412 projects, clinician throughput fell 25.2 percent at its trough and took 5.4 months on average to return to the pre go-live baseline, measured on scheduled visit volume in ambulatory settings and on work relative value units in acute settings. Academic medical centers fared worst on both readings, with a 31 percent peak drop and 8.3 months to recovery, which the sample attributes to teaching schedules, research effort allocations and a specialty mix that makes template rebuilds slower. Independent practices recovered fastest at 3.4 months, mostly because a five-physician practice can rebuild its templates in an afternoon and a 900-bed academic center cannot. Multi-hospital systems landed between the two at a 29 percent peak drop and 7.5 months to recovery, held back less by complexity at any one site than by the pace at which a shared build team can work through a queue of facilities.
None of this appears in the seven overrun lines from the earlier section, because none of it touches the project ledger. It lands instead on net patient revenue, on days in accounts receivable while coding catches up, and on the locum and per diem coverage that fills the gap. At $48,200 per clinician over the first twelve months, an academic medical center with 600 employed clinicians carries roughly $29 million of drag that no one approved and no one tracked against the implementation. Organizations that pre-funded a scheduled throughput reduction, typically a 20 to 25 percent template cut held for the first four to six weeks, showed shallower troughs and shorter recovery windows than those that went live at full schedule and absorbed the dip unplanned.
EHR Cost Overrun Trend by Go-Live Year
Grouping the sample by go-live year shows whether a maturing market has improved its estimating. It largely has, with one cohort that did not. Cohorts are assigned by first production go-live date, so a 2025 cohort project was measured through the third quarter of 2026.

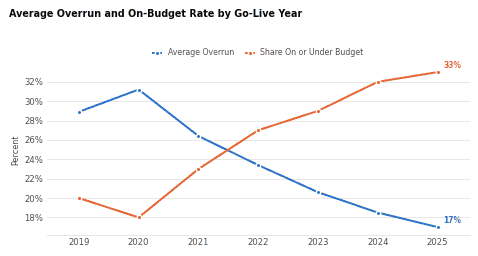

| Go-live year | Projects | Avg. overrun | On or under budget | Avg. schedule slip |
|---|---|---|---|---|
| 2019 | 44 | 28.9% | 20% | 4.6 |
| 2020 | 38 | 31.2% | 18% | 5.9 |
| 2021 | 56 | 26.4% | 23% | 4.3 |
| 2022 | 62 | 23.4% | 27% | 3.8 |
| 2023 | 68 | 20.6% | 29% | 3.2 |
| 2024 | 72 | 18.5% | 32% | 2.9 |
| 2025 | 72 | 17.0% | 33% | 2.6 |
Cohorts assigned by first production go-live date; schedule slip in months.
- We found average overrun falling from 28.9 percent among 2019 go-lives to 17.0 percent among 2025 go-lives, a decline of 11.9 points across seven cohorts. Average schedule slip fell alongside it, from 4.6 months to 2.6 months, against a sample-wide average of 3.7 months.
- Our data showed the 2020 cohort breaking the trend in both directions, at 31.2 percent average overrun and 5.9 months of average slip, the worst readings in the series. Those 38 projects went live into travel restrictions, remote training and a labor market that repriced implementation consultants inside a single quarter.
- EHR projects are getting more predictable, which lowers risk for buyers planning new rollouts. Average overruns fell from 28.9% in 2019 go-lives to 17.0% in 2025, and on-budget projects rose from 20% to 33%. If that trend holds, 2027 projects are likely to land closer to budget, though most will still run over.
Newer Published EHR Cost Figures
Federal audits and hospital financial disclosures released since this report first ran add public figures on the largest EHR programs and on recent Epic go-lives. We list them below, alongside our project study.
| Program or organization | Published figure | Source and date |
|---|---|---|
| VA EHR modernization, life cycle estimates | $16.1 billion (VA, January 2019); $49.8 billion (Institute for Defense Analyses, October 2022); about $48 billion, including about $11 billion of sustainment (VA, September 2026) | GAO-25-108091, February 2025; Military Times, September 2026 |
| VA EHR modernization, spending to date | $13.84 billion obligated from fiscal 2018 through March 2025, including $5.85 billion on the EHR contract and $3.35 billion on IT infrastructure | GAO-26-108812, December 2025 |
| VA Oracle Health contract ceiling | Raised from just under $10 billion to roughly $27 billion | Nextgov/FCW, August 2026 |
| DoD MHS Genesis integration contract (Leidos) | $4.3 billion at award in 2015, later about $5.5 billion, with a proposed $1.13 billion extension and a $263.3 million transition option | Nextgov/FCW, October 2024 |
| Memorial Sloan Kettering Cancer Center (Epic go-live February 2025) | $113.2 million operating deficit in the first half of 2025; $47.9 million for the full year, with about $177 million of expense growth tied to go-live support and training | MSK statement, 2025; Hoodline, May 2026 |
| Kaleida Health (Epic go-live May 2026) | $170 million rollout; $24.5 million of one-time operating costs through June; $21.1 million second quarter operating deficit | Becker's Hospital Review, August 2026 |
| Erie County Medical Center (Epic go-live planned for Q4 2026) | $35 million operating loss budgeted for 2026; $49.9 million capital budget for the Epic EHR and Infor ERP projects | ECMC 2026 budget, September 2025 |
- The VA program's own estimate reached about $48 billion in September 2026, roughly three times its January 2019 estimate of $16.1 billion.
- Through March 2025, the EHR contract made up $5.85 billion of the VA's $13.84 billion in obligations, or 42%, with infrastructure, program management, and clinical staff costs making up the rest.
- Recent Epic go-lives at MSK, Kaleida Health, and ECMC each came with operating losses that the organizations tied to the rollout, from $21.1 million in a quarter to $113.2 million in a half year.
What EHR Implementation Cost Overrun Trends Mean for 2027 and Beyond
Most EHR projects cost more than planned, and the larger and longer the rollout, the bigger the overrun. Each month of delay adds cost, so the schedule is one of the few things an organization controls that keeps spending in line.
Overruns have been getting smaller on recent projects, which suggests vendors and buyers are learning. Even so, large systems rolling out in phases still face the most risk, and staffing shortages or vendor changes could undo the gains.
So if you are planning an EHR project, set a firm schedule and budget for an overrun from the start, especially if the rollout spans several sites.
Requesting a Copy of This Report
A PDF of this report and the underlying 412-project dataset, including the budget and actual figures behind every table, are available on request to our research team.
Sources
- EHR Implementation Cost Overrun Study, Healthcare Industry Reviews, September 2026, New York, New York.
- Most Expensive EHR Projects Underway in 2026, Ranked, Becker's Hospital Review, August 2026, Chicago, Illinois. beckershospitalreview.com
- VA Said Electronic Health Record Modernization Would Cost $10 Billion, Now It's $48 Billion, Military Times, September 2026, Vienna, Virginia. militarytimes.com
- VA Boosts EHR Modernization Contract With Oracle by $17B, Nextgov/FCW, August 2026, Washington, District of Columbia. nextgov.com
- Rip the Band-Aid Off: Health Systems Opt for Big Bang Epic Go-Lives, Becker's Hospital Review, October 2025, Chicago, Illinois. beckershospitalreview.com
- Unpacking Hospitals' EHR Implementation Costs: What's Behind the Million-Dollar Price Tags, Becker's Hospital Review, May 2016, Chicago, Illinois. beckershospitalreview.com
- Electronic Health Record Modernization: VA Is Making Incremental Improvements, but Much More Remains to Be Done, GAO-25-108091, US Government Accountability Office, February 2025, Washington, District of Columbia. gao.gov
- VA Electronic Health Record Modernization: Critical Actions Needed to Support Accelerated System Deployments, GAO-26-108812, US Government Accountability Office, December 2025, Washington, District of Columbia. gao.gov
- DOD Plans $1.4B Sole Source Extension for Leidos on Health Care Record, Adam Mazmanian, Nextgov/FCW, October 2024, Washington, District of Columbia. nextgov.com
- MSKCC Issues Statement on Second Quarter 2025 Financial Results, Memorial Sloan Kettering Cancer Center, 2025, New York, New York. mskcc.org
- Epic Rollout Smacks Sloan Kettering With $48 Million Loss, Hoodline, May 2026. hoodline.com
- Kaleida Health Posts $21.1M Q2 Deficit Amid Epic Rollout, Naomi Diaz, Becker's Hospital Review, August 2026, Chicago, Illinois. beckershospitalreview.com
- 2026 Operating and Capital Budgets, Erie County Medical Center Corporation, September 2025, Buffalo, New York. ecmc.edu
HIR Research notes are editorial. No vendor paid for inclusion.
